You’re tracking project costs and monitoring schedules—but something still feels off. The numbers say you’re on track, yet unexpected cost overruns keep showing up. Delays pile up. Profit margins shrink.
You've realized that tracking spending alone isn’t enough. You need a way to measure how much value that spending is actually creating. That’s where Earned Value Analysis (EVA)[?] comes in. It can tell you whether the work done so far is worth what you’ve spent and whether you're on track to finish within budget and schedule.
But here’s the challenge: implementing EVA isn’t as simple as running a few formulas. Progress data isn’t always reliable, cost reporting can be inconsistent, and not everyone on the team understands how to use EVA insights to make better decisions.
This guide will help you bridge that gap. Instead of just explaining EVA, we’ll focus on how to apply it effectively in real construction projects — so you can catch problems early, make informed decisions, and keep your project on track.
What is Earned Value Analysis?
Earned value analysis is a project management technique that combines schedule, cost, and scope measurements to evaluate project performance and progress.
Normal project tracking just looks at how much money you've spent. Earned Value Analysis goes further, checking if you're actually getting the work done that you paid for so far.
Key Components of Earned Value Analysis
-
Planned value represents the budgeted cost of work scheduled at a specific point in time. For example, if you planned to complete $100,000 worth of foundation work by week 4, that's your PV. This baseline metric serves as a reference point for measuring project performance.
-
Actual cost reflects the real costs incurred for work completed to date. Using the same example, if the foundation work actually costs $110,000, the latter number will be the actual cost. This component provides a clear picture of how much money has been spent on the project so far.
-
Earned value measures the budgeted cost of work completed. If only 80% of the foundation work is complete, your EV would be $80,000 (80% of the planned $100,000). This metric helps determine whether the project is delivering value in line with expenditure.
Achieve peak productivity on site
Manage teams, equipment, and materials in FirstBit
Request a demo
EVA Metrics for Measuring Project Performance
Behind every successful project lies a set of key performance indicators (KPIs) that tell the true story of progress and efficiency. Project managers use several KPI metrics to evaluate performance.
Cost Variance (CV) reveals whether a project is under or over budget by comparing Earned Value to Actual Cost.
Cost Variance (CV) = Earned Value (EV) - Actual Cost (AC)
Schedule Variance (SV) indicates whether work is ahead or behind schedule by comparing Earned Value to Planned Value.
Schedule Variance (SV) = Earned Value (EV) - Planned Value (PV)
The Cost Performance Index (CPI) shows how well you're managing your budget by measuring cost efficiency.
Cost Performance Index (CPI) = Earned Value (EV) ÷ Actual Cost (AC)
Meanwhile, the Schedule Performance Index (SPI) reveals how effectively you're using time by measuring schedule efficiency.
Schedule Performance Index (SPI) = Earned value (EV) ÷ Planned Value (PV)
When it comes to evaluating performance, both CPI and SPI indices use the same scale. A value greater than 1 indicates strong performance – in costs, this means you're spending less than planned, while in scheduling, it shows you're completing work faster than expected.
Lastly, the Expected Final Cost (EAC) formula, calculated as Budget at Completion (BAC) divided by the Cost Performance Index (CPI), provides a projection of the total project cost based on current spending efficiency. A lower CPI indicates overspending and leads to a higher EAC, signaling potential budget overruns.
Expected Final Cost (EAC) = Budget at Completion (BAC) ÷ Cost Performance Index (CPI)

The graph below, obtained using FirstBit ERP, shows how well our project is doing over five months, tracking key measures like CPI (Cost Performance Index) and SPI (Schedule Performance Index). Using EVA metrics, we can produce a snapshot of our project’s success that is easy to analyse.
The important thing to notice is when the CPI and SPI dip below 1.0. This happened in Months 1, 2, and 5, and it's a sign that we might be having problems with our budget and schedule. This is because negative CV and SV went down in those periods.
It could be because we didn't estimate costs correctly, things are taking longer than expected, we can't get the resources we need, or the scope of the project has expanded. When the CPI is low, we need to look closely at where we're spending money and find ways to cut costs.
How do we master costs? Read the guide on the topic: 8 Steps to Mastering Construction Cost Estimating—Firstbit Blog.
Benefits of Earned Value Analysis
Tracking a construction project's progress helps you meet deadlines and stay within budget. But EVA offers more benefits than just that.
1. Real-Time Progress Monitoring
Traditional project tracking methods often rely on outdated reports, making it difficult to spot delays before they become costly problems. Earned Value Analysis (EVA) changes this by providing real-time visibility into both cost and schedule performance.
Instead of waiting until the end of a phase to assess progress, EVA allows construction teams to detect early warning signs of trouble, such as:
-
Work falling behind schedule. If Earned Value (EV) is lower than Planned Value (PV), it means less work has been completed than planned, signaling a delay.
-
Cost overruns. If Actual Cost (AC) is higher than Earned Value (EV), the project is overspending compared to the value of work completed.
-
Inefficient resource use. A project may appear on the budget but still be behind schedule, indicating labor or material inefficiencies that need correction.
These insights allow teams to act immediately, adjusting workloads, reallocating resources, or revising schedules before minor issues turn into major setbacks.
2. Smart Daily Planning
Normally, daily planning is often just guessing. Earned Value Analysis (EVA) changes this by giving you a clear way to manage resources and schedule tasks each day using actual numbers. Instead of just hoping things will work out, EVA helps you see problems before they happen.
For example:
-
Not enough resources. By comparing how much work you plan to do each day with how many workers and machines you have, you can see if you might run short. This keeps you from starting work without what you need.
-
Wasting resources. If you're spending more money on a daily task than the work you're actually getting done, it means you're using resources poorly. EVA helps you find these problems so you can move workers around or change how you're doing things.
-
Trying out different plans. EVA helps you test different ideas. You can see what would happen if you added an extra shift, used different equipment, or changed the orders or priorities of tasks. This helps you find the cheapest way to get the job done while tracking any problems you're seeing now.
This clear information helps you make better choices every day. This means fewer delays, better use of workers and machines, and a project that finishes on time and on budget.
3. Problem Prevention
Traditional project monitoring often struggles to provide early warnings, especially in large construction projects. Earned Value Analysis changes this by giving constant oversight, which quickly can help a company adapt quicker.
EVA is very helpful with projects like these, giving companies an option to see problems early on. For example, when building a hospital, it might show that material costs are trending higher than planned from the first day. This allows businesses to switch providers and suppliers and adjust procurement strategies before the issue becomes bigger in the future.
4. Multi-Team Performance Tracking
When you have many teams working on different parts of a big construction project, it can be hard to see if everyone is working together well and if the company has a centralized location.
Earned Value Analysis can assist you in this area. EVA gives you one clear place to track all work so you can see how different teams are doing for a centralized location of resources that all can access.
For example, if the electrical team falls behind schedule, EVA will reflect this while also showing how it affects the work of the plumbing team and other subcontractors. This way, project managers can see which areas affect one another.
This process can be automated using tools such as ERP systems. For instance, FirstBit ERP gives contractors a single dashboard showing all team progress, costs, and deadlines, revealing exactly where teams align or conflict so they can proactively address potential roadblocks in construction projects.
5. Project Control and Stakeholder Management
EVA keeps you in control with reliable data. For renovation projects, it helps compare actual work completed against the original scope, making it easier to justify change orders and keep stakeholders informed of progress.
Stay ahead of delays
Request a demo
How to Implement Earned Value Analysis in Construction Projects
The initial setup of Earned Value Analysis in construction projects is quite time-consuming, but by approaching implementation in well-defined phases, you can speed up this process.
Step 1: Set Up Project Structure
Start by breaking down your project into clear, manageable tasks. Identify every construction activity that needs to be completed, create a logical sequence, and assign specific timeframes and costs to each task. This creates a clear roadmap for your project.
Step 2: Create Your Baseline
Establish your initial project plan with detailed scheduled dates and budgeted costs. This baseline becomes the standard against which all future progress will be measured. Think of it as your project's foundation — it needs to be solid and well-thought-out.
Step 3: Choose Measurement Methods
Determine how you'll measure progress for each task in your project. You might measure foundation work by percent complete, while window installation might be measured by units completed.
Select methods that make sense for each specific task and are easy to track. Analyze each task's characteristics: continuous activities suit "percent complete," while discrete tasks benefit from "units completed." Prioritize objective, verifiable data and align methods with the Work Breakdown Structure.[?]
Step 4: Start Tracking
Begin gathering precise project data as work progresses, meticulously tracking completed work, money spent, time used, and resources consumed. This data collection should become a regular part of your daily project management routine.
Implement efficient tracking processes like progress reports, timesheets, expense records, and inventory data. Construction ERP systems can streamline this process by consolidating information from multiple sources into a single platform, automating report generation, and providing real-time visibility into project performance. Regularly record the things mentioned above to get the desired result.
Step 5: Calculate Performance
Regularly analyze your project's performance using EVA formulas. Calculate your Cost Performance Index to understand how well you're managing costs, and your Schedule Performance Index to gauge if you're meeting timeline goals. This should be done at consistent intervals throughout the project.
The ideal interval depends on the project's length and complexity. For shorter projects (less than six months), analyze weekly or bi-weekly. For longer projects, monthly analysis is common.
Consider more frequent analysis if you're nearing a critical milestone or experiencing known cost or schedule pressures. The key is to identify potential issues early enough to take corrective action.
Step 6: Report and Adjust
Create and distribute regular progress reports to keep all stakeholders informed. Use the insights from your EVA calculations to make necessary adjustments to your project plan.
For example, if EVA reveals a CPI consistently below 1.0, indicating cost overruns, re-evaluate your budget allocations, renegotiate supplier contracts, or optimize resource utilization. If your SPI is consistently below 1.0, indicating schedule delays, consider re-prioritizing tasks, allocating additional resources to critical path activities, or adjusting project timelines.
If you spot issues, address them promptly and update your plans accordingly. Regular communication and quick responses to problems help keep your project on track.
EVA in Practice
Consider a Dubai residential project where EVA revealed that while wall construction was on schedule, material costs were 15% over budget by week 6. This early warning allowed the project manager to renegotiate supplier contracts before the issue affected the entire project timeline.
The project involves constructing a six-story residential building with underground parking. The total Budget At Completion (BAC) – which is the original approved budget – is set at 5 million AED with a planned duration of 12 months.
Project situation: we're now at the 6-month mark, exactly halfway through the planned timeline. According to the original schedule, the structure should be complete, and MEP work should be starting.
Let's analyze where we actually stand:
-
The original Budget At Completion (BAC) was set at 5,000,000 AED
-
By this point, we should have completed work worth 2,500,000 AED (Planned Value)
-
However, we've only completed work worth 2,000,000 AED (Earned Value)
-
Even worse, we've already spent B (Actual Cost - AC)
Let's calculate how efficiently we're using our resources using performance analysis metrics.
Cost performance indicator:
CPI = EV/AC = 2,000,000/2,800,000 = 0.71
This is concerning - for every 1 AED we're spending, we're only getting 0.71 AED worth of work done. The main causes are increased material costs and some rework in the foundation.
Schedule performance:
SPI = EV/PV = 2,000,000/2,500,000 = 0.80
We're falling behind schedule, completing only 80% of the planned work. This delay was mainly due to unexpected groundwater issues during excavation.
Project forecast if this trend continues:
Expected Final Cost (EAC) = BAC/CPI
EAC = 5,000,000/0.71 = 7,042,253 AED
This means that our analysis reveals that without immediate intervention, this project is heading towards:
-
A budget overrun of more than 2 million AED
-
A significant schedule delay that could affect the delivery date
-
Potential penalties from the client and dissatisfied stakeholders
The project manager needs to take immediate corrective actions, such as:
-
Reviewing and optimizing construction methods
-
Accelerating MEP works
-
Negotiating better rates with suppliers
-
Possibly adding resources to recover the schedule
This is a very basic analysis example. In reality, EVA asks for more calculations. However, modern tools like the FirstBit ERP system automate these calculations and provide instant alerts when projects deviate from their targets. The system tracks these budget variations, and schedule deviations become automatic, allowing for instant alerts when projects start to drift from their targets.
Keep projects running like clockwork
Schedule tasks in FirstBit
Request a demo
Challenges of Earned Value Analysis
Construction companies, particularly those in the Middle East's fast-paced market, often struggle with implementing Earned Value Analysis effectively. Here's why:
-
Initial setup and complexity. The complex setup process is often the first hurdle, requiring detailed project breakdowns and precise cost allocation that can take weeks or months to establish properly. This initial configuration can strain project timelines before work even begins. The sheer volume of data and interconnected tasks in construction projects makes this particularly challenging.
-
Data management and accuracy. Construction teams struggle with collecting accurate, real-time data, especially from multiple sites and sources. This often leads to calculation errors and delayed reporting, which defeats the purpose of using EVA for proactive project control. Without reliable data, the entire analysis becomes questionable and might lead to misguided decisions.
-
Resource and training requirements. The resource demands of maintaining an EVA system are substantial. Companies need dedicated staff for monitoring and updating the system, plus significant investment in training team members. This creates an ongoing operational cost as team members must understand not just the basics but the nuances of EVA application in various project scenarios like how to properly assess percent complete in partially finished work, handle change orders' impact on baseline calculations, account for material price fluctuations in earned value metrics, and adjust performance indices for seasonal construction variations.
-
Implementation and integration. Teams often resist adopting new methods, while the learning curve can slow down projects initially. Integrating EVA with existing processes requires careful change management and might disrupt established workflows. This is particularly challenging in construction, where traditional methods like manual documentation are deeply ingrained.
-
Continuous monitoring and updates. Maintaining the EVA system requires constant attention and updates to reflect project changes. This ongoing maintenance demands significant time and effort, especially in dynamic construction environments where scope and conditions frequently change.
With proper planning, modern technology, and systematic approaches, these obstacles can be overcome to realize the full benefits of Earned Value Analysis in construction project management.
Project management software will also help you smooth out obstacles to using EVA in your construction project. Systems like FirstBit ERP will transform what was once a labor-intensive process into a more manageable and accurate system for tracking project progress and performance.
Enhancing EVA with ERP Systems
Instead of wrestling with spreadsheets and manual calculations, these systems automatically gather data and crunch the numbers.

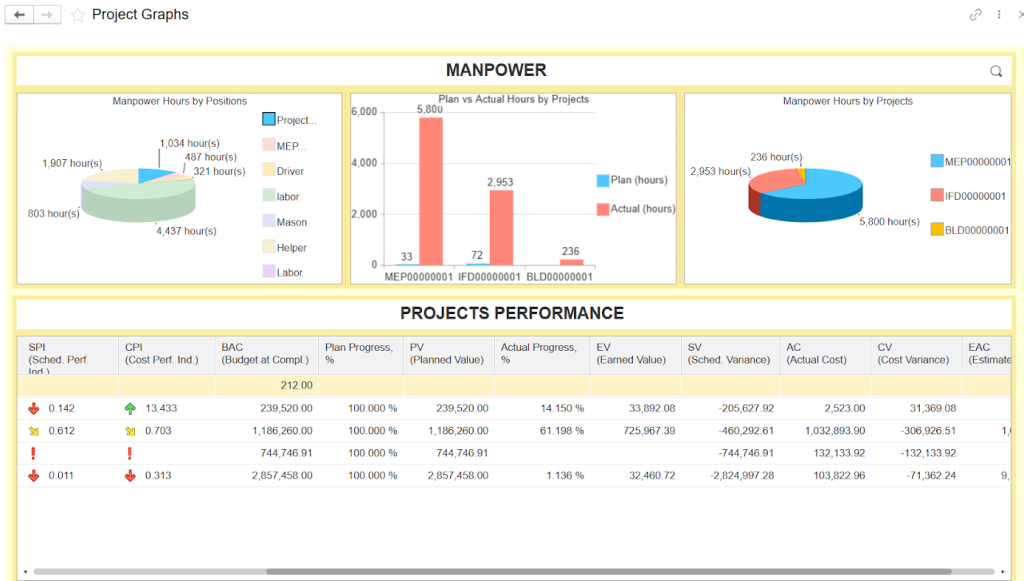

You get clear, visual dashboards showing exactly how your project is performing right now and automatic reports that help your team make smart decisions quickly.
